The RMA Is Being Replaced: What It Means If You Own Land You Want to Develop

New Zealand has passed laws to replace the RMA. The rules for your land don't change overnight, but the transition began on 30 October 2026. Here's what landowners need to know, and when.

IlyaDirector and Development Manager
26 September 20269 min read
Aerial view of an Auckland road running past homes and green open land, with the sea on the horizon

Updated 11 November 2026: The Planning Act 2026 and Natural Environment Act 2026 received Royal Assent on 30 September. The RMA and existing plans still govern resource consents while the new system is introduced. Some RMA changes took effect on 1 October, and the transition period, with targeted changes to how certain consent applications are assessed, began on 30 October. National standards and regional plans will follow in stages. If you’re preparing an application, ask your planner which rules apply to your site and your lodgement date.

What's happening, in plain English

Think of the RMA as a very old rulebook. For 35 years it has decided what you can build or change on your land, and when you need the council's permission first.

Many people, including the Government, say that rulebook became slow, expensive and confusing. The Government says New Zealand has more than 1,100 planning zones, each with its own rules.

On 22 September 2026, Parliament voted to replace it with two new laws: the Planning Bill, about land use and building, and the Natural Environment Bill, about protecting nature. They aim to make the rules simpler and more consistent, and to reduce how many things need permission.

It hasn't fully happened yet. Two things are still to come:

  1. The detail. The laws set the framework. The specific rules, like exactly what you can build without asking, will be written later.
  2. The switch. Each region needs to write a new plan first. Until then, the old rules keep applying there, with some changes.

A resource consent is council permission for something the rules don't automatically allow, like splitting your land into more than one title or building more than the rules permit.

Often, yes. Officials estimate that around 45% of the consent and permit applications currently required under the RMA could become unnecessary. That's a forecast, not a promise, and it means most would still be needed. The reforms are intended to remove permission requirements for more ordinary, low-impact activities, but the final national rules have not yet been made. In our view, bigger projects, such as several homes on one site or land with hazards or overlays, are more likely to still need consent.

Protections stay for heritage buildings, sites important to Māori, natural hazards and specially protected landscapes.

What changed first (30 October 2026)

The transition period began on 30 October 2026. The old law now applies with some changes. For district land-use consents, councils must ignore:

  • for homes, except where historic heritage is being protected: the amount of glazing, balconies, outdoor living space, internal layout, the size of a home, and the size of landscaped areas (except where it relates to permeability)
  • competition with other businesses, and effects on retail distribution
  • whether there's demand for the project, or whether it's financially viable
  • the type of people who'll live there
  • views from private property

The date you lodge matters. Applications lodged before the transition started continue under the earlier rules. Applications lodged since then are assessed under the changed rules. Ask your planner which suits your project.

Some rule breaches may be treated as permitted. Councils can now confirm that a project which only breaks a rule about one of the ignored matters is permitted, so you may avoid a consent. It's the council's choice, and the confirmation lapses after five years if you don't start work.

Can I still subdivide my land?

You can still seek to subdivide under the rules that apply to your property. Under the future system, the Ministry for the Environment says subdivision will generally be allowed unless a national standard or local rule restricts it, with safeguards for natural hazards (like flooding) and infrastructure (like services, roads, etc.) That does not make subdivision consent-free today. Current requirements continue during the transition, subject to applicable amendments and new national standards.

What about my neighbours?

For district land-use applications lodged during the transition, neighbours may have fewer relevant grounds on which to participate. Councils can consider fewer effects, and the same shorter list applies when deciding whether to notify people about a consent application. If you're the one developing, that may make consents smoother. If you're a neighbour, expect fewer chances to have a say.

When will it actually change?

Royal Assent was on 30 September 2026, so the statutory deadlines now run from that date.

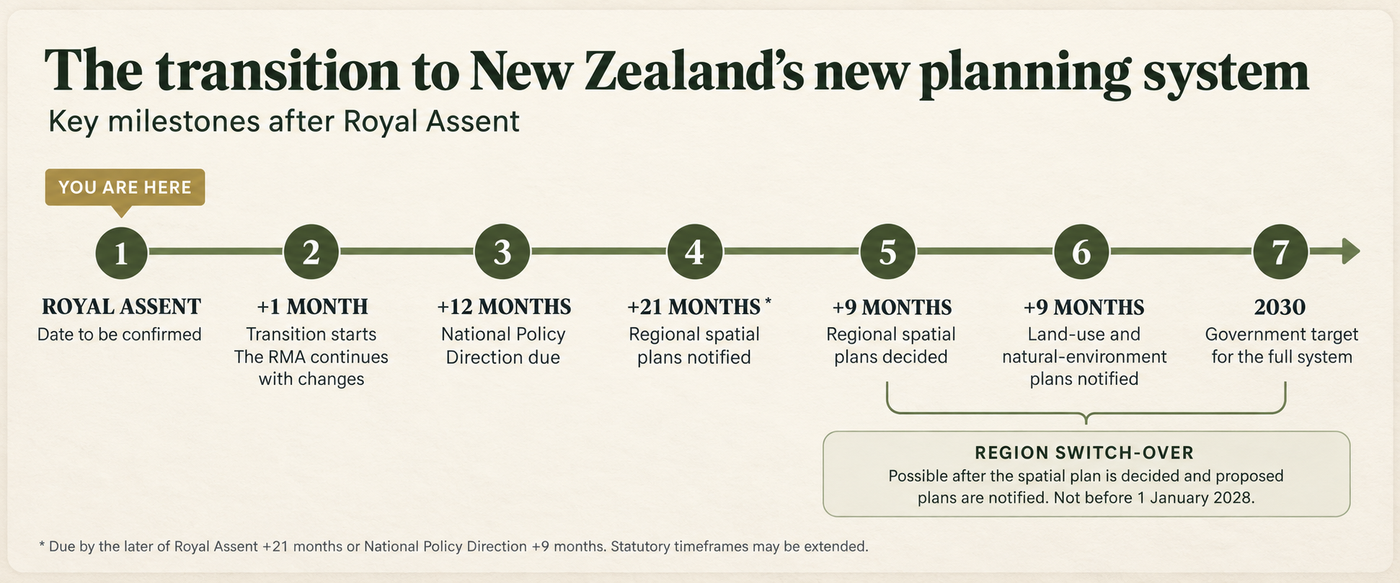

Timeline showing the milestones from Royal Assent through the RMA transition to the Government’s 2030 target.
Timeline showing the milestones from Royal Assent through the RMA transition to the Government’s 2030 target.

WhatWhen
Parliament passes the laws22 September 2026 (done)
Royal Assent (final sign-off)30 September 2026 (done)
Transition period starts30 October 2026 (started)
Regional plans first published as draftsAround mid-2028 (by the later of 21 months after Royal Assent, or 9 months after national policy is issued)
Councils decide those plansWithin 9 months
Detailed rules for your area publishedWithin 9 months after that
Your region switches to the new systemNot before 31 December 2027. On the legal deadlines, most likely late 2029 or later
Government's target for the whole country2030

These are deadlines, not minimum waits, so a region that finishes early could switch sooner. Some law firms expect the RMA to be fully repealed by late 2030. When your region switches, the old rules stop and the rules in the new draft plans start to apply, even if the plans aren't finalised.

Your regional plan matters early. Once your region's plan is decided, councils must consider whether a consent fits with it, even before the new system fully starts.

In Auckland, the Auckland Unitary Plan keeps applying until Auckland switches over. Auckland Council said in February 2026 that it supports a more efficient system, but wants local voices to have a stronger say.

What should I do now?

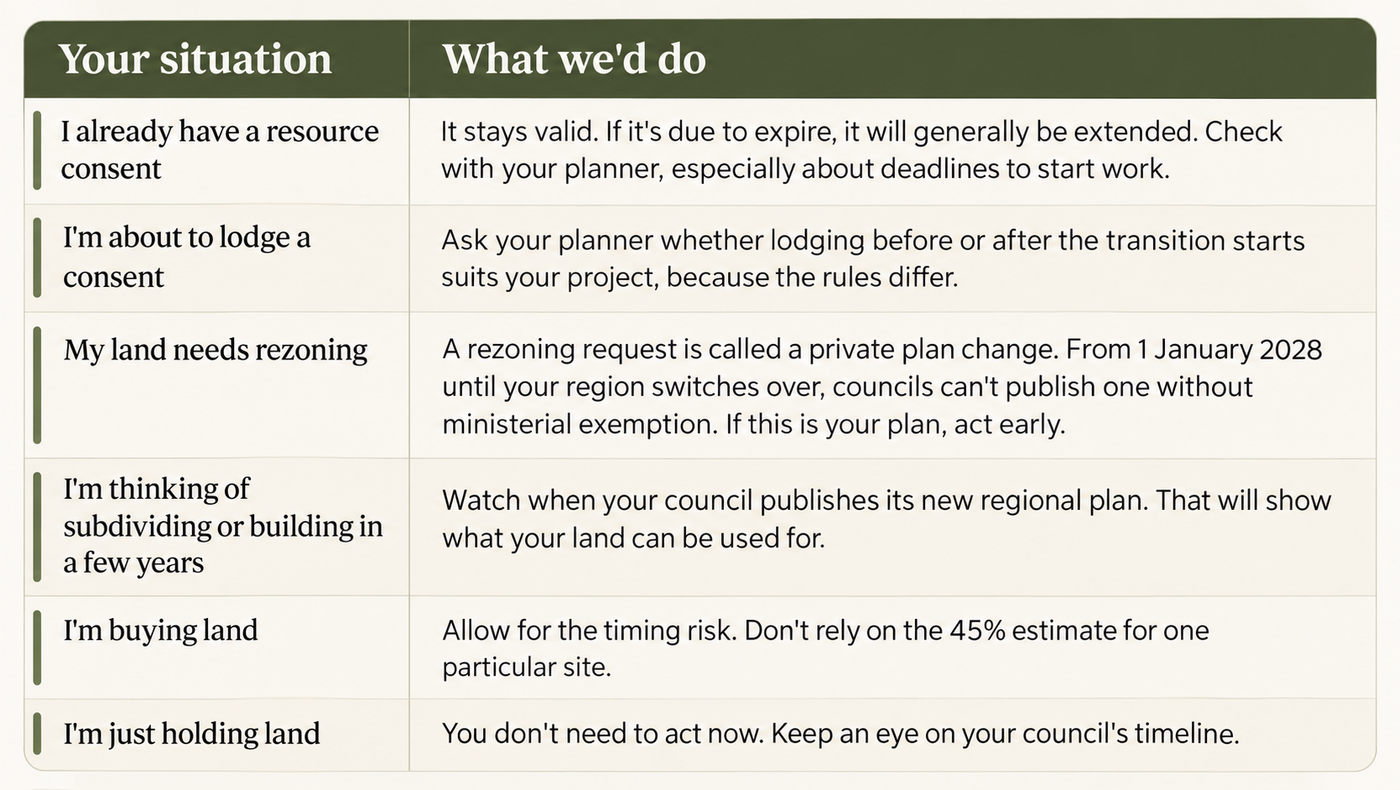

Your situationWhat we'd do
I already have a resource consentIt stays valid. If it's due to expire, it will generally be extended. Check with your planner, especially about deadlines to start work.
I'm about to lodge a consentNew applications now fall under the changed rules. Ask your planner how they apply to your project.
My land needs rezoningA rezoning request is called a private plan change. From 1 January 2028 until your region switches over, councils can't publish one without ministerial exemption. If this is your plan, act early.
I'm thinking of subdividing or building in a few yearsWatch when your council publishes its new regional plan. That will show what your land can be used for.
I'm buying landAllow for the timing risk. Don't rely on the 45% estimate for one particular site.
I'm just holding landYou don't need to act now. Keep an eye on your council's timeline.

Other changes to know about

  • New levies. The Government can set a levy on consents and registered permitted activities, to fund national rules and monitoring. No amounts are set yet, so allow for it on top of existing council fees.
  • Rezoning may get easier. Once your region switches over, your council can choose to handle a rezoning request like a consent application, which could be faster than a full plan change. It's the council's decision.
  • A new Planning Tribunal. It's meant to be a cheaper, faster way to settle disputes with councils. The Government's own transition timeline lists 2027 for the Tribunal, though the exact date is still to be confirmed.

What nobody knows yet

  • Which activities won't need consent. That depends on national rules that haven't been finalised. Feedback on the draft closed on 16 October 2026.
  • What happens after the election. The general election was held on 7 November 2026. On preliminary results the governing coalition has a slim majority, with official results due on 27 November. The laws don't have cross-party support. NZ has been here before: a similar replacement law passed in August 2023 and was repealed by December 2023. The New Zealand Initiative says the detailed rules will be written later, and can be changed through set consultation processes without going back to Parliament. Environmental groups say the laws weaken nature protection and expect court challenges.
  • How "regulatory relief" will work. If a rule seriously limits what you can do with your land (for example heritage or protected natural areas), the council may have to offer relief, like reduced fees or rates, extra development rights or money. It doesn't have to cover the full impact. How this works in practice is untested.

Words explained

  • RMA (Resource Management Act): the current planning law, in place since 1991.
  • Resource consent: council permission for something the rules don't automatically allow.
  • Subdivision: splitting one piece of land into two or more titles.
  • Zoning: the rules that say what can be built in an area, like homes or businesses.
  • Regional spatial plan: a 30-year map of where a region will grow and where infrastructure and protections will go.
  • Private plan change: a request to change the rules or zoning for your land.
  • Royal Assent: the Governor-General's sign-off that makes a law official.
  • Transition period: the time between the laws starting and your region switching to the new system.

How we can help

At Creston Property, we track regulatory timelines like this as part of assessing what's possible on a site. If you own land in Auckland and want to know how these changes affect your options, get in touch or visit www.crestonproperty.co.nz.

For a project moving from consent into delivery, see our residential construction services in Auckland for design-and-build and construction-only projects.

Share this article

FAQ

Frequently asked questions

Yes. The RMA applies until your region is switched to the new system. On the legal deadlines, that's unlikely before late 2029 for most regions. It has applied with some changes since 30 October 2026.
